How to Estimate Renovation Costs Accurately

Hootan Nikbakht

Hootan Nikbakht

Real Estate Expert

September 28, 2025
22 min read
How to Estimate Renovation Costs Accurately

Before you can nail down an accurate renovation budget, you have to break the project down into its four essential parts: labor, materials, permits, and a contingency fund. A detailed scope of work is your financial roadmap, guiding every single dollar from the first swing of a sledgehammer to the final coat of paint. It's what keeps those nasty, expensive surprises at bay.

Laying the Groundwork for Your Renovation Budget

Forget about picking out tile or faucets for a minute. The very first thing you need is a rock-solid financial plan. Moving from a vague "ballpark" number to a line-by-line estimate is the single most critical step to keeping your project on time and, more importantly, on budget. Trust me, a fuzzy idea of costs is a surefire way to end up in a financial mess. A detailed breakdown, on the other hand, lets you make smart, confident decisions right from the start.

This early planning is more than just crunching numbers in a spreadsheet. It’s about taking a hard, honest look at what really drives the costs in a project. Think of it as doing due diligence on your own renovation plans. This process is just as fundamental as the property evaluation steps we outline in our real estate due diligence checklist—that crucial upfront work that prevents major headaches down the line.

The Four Pillars of a Renovation Estimate

No matter how big or small your project is, every renovation budget is built on the same foundation. Getting a handle on these key components is the only way to see the full financial picture.

  • Labor Costs: This is often the biggest piece of the pie. It covers the wages for all the skilled pros you'll need—plumbers, electricians, carpenters, painters, and everyone in between.
  • Material Costs: This bucket holds everything from the big structural stuff like lumber and drywall down to the finishing touches like flooring, countertops, and light fixtures.
  • Permits and Fees: Depending on where you live and what you’re doing, you’ll need to budget for city permits, inspection fees, and sometimes even architectural or engineering drawings.
  • Contingency Fund: This is your "just in case" money, and it's non-negotiable. A buffer of 10-20% of your total project cost is the industry standard for handling the inevitable unexpected problems that always pop up.

A clear understanding of these categories is the first step in building a realistic budget. The table below breaks down how these components typically fit together.

Core Components of a Renovation Budget

Cost CategoryTypical Percentage of BudgetWhat It Covers
Labor40% - 60%Wages for all contractors and subcontractors (e.g., plumbers, electricians, painters).
Materials30% - 50%All physical items: lumber, drywall, flooring, fixtures, paint, appliances, etc.
Permits & Fees1% - 5%Building permits, inspection fees, architectural plans, engineering reports.
Contingency10% - 20%Unexpected issues: hidden rot, unforeseen structural problems, material delays.

Getting these percentages right from the start gives you a strong framework and helps you allocate funds where they'll be needed most.

Understanding Market Dynamics

Lately, pinning down exact costs has gotten trickier. We've seen a huge demand for skilled contractors but a limited supply, which has naturally driven labor costs up. At the same time, global supply chain hiccups have made material prices incredibly volatile.

It’s not unusual these days for materials alone to eat up over 50% of the total project cost, so you absolutely have to account for these market shifts.

A well-defined scope of work is your best defense against budget overruns. It forces you to make decisions upfront, turning abstract ideas into a concrete plan that contractors can price accurately.

By starting with these foundational components, you create a solid structure for your entire project. This methodical approach takes the overwhelming task of estimating a renovation and turns it into a clear, manageable process.

Defining Your Project Scope and Vision


Saying "I want to redo the kitchen" is a bit like telling a car dealer "I want a new car." It’s a starting point, but it's not nearly enough information to get a real price. This is where a lot of people go wrong, and it's why initial estimates can be so wildly inaccurate.

To get a number you can actually trust, you have to translate that big idea into a precise, detailed plan. This is your first and most important step in controlling your budget—long before you even think about talking to a contractor.

Think of it as creating a detailed instruction manual for your renovation. It needs to be specific enough to remove all guesswork. Instead of "new kitchen," a solid scope would read more like this: "Demolish and dispose of all existing cabinetry and flooring. Replace 150 sq ft of vinyl with mid-grade LVP. Install 30 linear feet of new shaker-style cabinets. Install new quartz countertops and an undermount sink."

See the difference? That level of clarity is everything. When you create a document with this detail, often called a scope of work (SOW), you're arming yourself with the single best tool for getting apples-to-apples quotes. Every contractor bids on the exact same project, so you can compare their skill and value, not just a vague number they pulled out of thin air.

Differentiating Wants From Needs

Once you start listing everything you’d love to do, that budget can balloon pretty quickly. This is where you need to get honest with yourself and separate the absolute must-haves from the nice-to-haves. It's not about killing your dream project; it’s about being smart and strategic.

Your must-haves are the non-negotiables—the things that are essential for the project to even make sense. This usually comes down to safety, functionality, and structural integrity.

  • Must-Haves (The Essentials):
    • Fixing a leaking roof or patching a cracked foundation.
    • Replacing old, dangerous electrical wiring.
    • Putting in a new water heater that actually works.
    • Making sure the layout is functional for daily life.

On the other hand, the nice-to-haves are the upgrades. They add style and luxury, but the room would still work without them. These are your flexible items and the first things to look at if costs start creeping up.

  • Nice-to-Haves (The Upgrades):
    • Imported Italian marble countertops when a quality granite will do the job beautifully.
    • Smart home features like automated lighting or blinds.
    • Fully custom cabinetry when stock or semi-custom options would fit perfectly.
    • A high-end, pro-grade appliance package when a reliable mid-range set would suffice.

Simply sorting your list into these two columns gives you an immediate roadmap. If the numbers come in high, you already know where you can make cuts without derailing the whole project or making a panicked decision on the spot.

Prioritizing your project scope isn't about sacrificing your vision; it's about executing it intelligently. Knowing your must-haves ensures the core of your project is solid, while the nice-to-haves provide flexibility to stay on budget.

Creating a Detailed Specification Sheet

With your priorities locked in, it's time to drill down even further with a specification sheet, or "spec sheet." This document gets into the nitty-gritty of every single material, finish, and fixture you plan to use. It’s the micro-level detail that supports your high-level scope of work.

For example, just writing "new bathroom faucet" on your list is a recipe for budget disaster. Does that mean a basic $50 chrome faucet from a big-box store, or a designer $500 brushed brass model? That ambiguity is exactly where projects go off the rails.

Your spec sheet should have columns for:

  1. Item Name: Get specific. Not just "faucet," but "Kitchen Sink Faucet."
  2. Brand/Model: If you know it, write it down (e.g., "Delta Trinsic Single-Handle").
  3. Material/Finish: Note the exact look (e.g., "Champagne Bronze").
  4. Size/Dimensions: Add any key measurements (e.g., "Fits standard 3-hole sink").
  5. Budgeted Cost: Put a number down for what you plan to spend on that item.

When you hand this level of detail to a contractor, you eliminate all their guesswork. Their quotes will finally reflect your actual vision and quality standards. It takes some real effort upfront, but it pays off big time by preventing misunderstandings and expensive change orders down the road. This is the secret to a predictable and successful renovation.

Understanding Key Renovation Cost Drivers


It’s the question I hear all the time: why can one kitchen remodel cost $20,000 while a seemingly identical one down the street balloons to $80,000? The truth is, a handful of powerful cost drivers can dramatically inflate or control your final price tag.

If you want to create a realistic estimate and avoid that dreaded sticker shock, you have to get a handle on these factors. They go far beyond just the size of the room and include everything from the quality of materials you choose to the complexity of the labor involved.

The Big Three: Labor, Materials, and Complexity

At the heart of any renovation estimate are three interconnected forces: the people doing the work, the stuff they’re installing, and how difficult the job actually is. Master how these three interact, and you'll master your budget.

  • Labor Rates and Availability: Your zip code is one of the single biggest factors. It’s no surprise that labor rates in a major city like New York or San Francisco will be worlds apart from those in a rural town. A local shortage of skilled tradespeople can also drive up prices as demand simply outstrips supply.

  • Material and Finish Quality: This is where your personal taste directly hits the bottom line. Choosing builder-grade vinyl flooring is a completely different financial decision than selecting high-end, imported hardwood. The same goes for cabinetry—stock options from a big-box store are a fraction of the cost of fully custom cabinets.

  • Project Complexity: A simple cosmetic facelift—fresh paint, new light fixtures—is pretty straightforward. But the second you decide to move a wall, reroute plumbing, or touch the electrical layout, the complexity and cost skyrocket. These changes demand more skilled labor, extra permits, and more time, all of which add up fast.

The real cost of a renovation isn't just in the items you see; it's in the complexity hidden behind the walls. Moving a single plumbing line can involve a plumber, a carpenter to open and close the wall, and a painter to patch and finish—turning a small change into a multi-trade expense.

The Hidden Costs of Structural and Mechanical Changes

While new countertops and flooring are the exciting parts of a remodel, the biggest budget-busters are often the things you can't even see. Structural and mechanical adjustments are notorious for blowing budgets because they require specialized, licensed pros and have a nasty habit of uncovering other problems that need fixing.

For instance, knocking down a wall to create that dreamy open-concept living space seems simple on paper. But what if that wall is load-bearing? Suddenly, you're on the hook for an engineer's assessment, a massive support beam, and the skilled crew to install it. What looked like a simple demolition job just morphed into a major structural project.

The same rule applies to your mechanical systems. Rerouting pipes for a new bathroom layout or upgrading an old electrical panel to handle modern appliances requires expensive, skilled labor. These are not the places to cut corners with DIY—a mistake can be dangerous and incredibly costly to fix. Remember, delays during these complex phases also rack up holding costs. You can explore our guide on the real cost of holding a property to see how timelines impact your bottom line.

The Impact of Market Conditions and Inflation

You can’t budget for a project in a vacuum. Broader economic trends play a massive role in what you'll pay for both materials and labor. Over the past few years, wild inflation and supply chain nightmares have made this crystal clear.

Just look at the data. A 2024 survey from the National Association of Home Builders showed that new construction costs soared to account for 64.4% of a home's sales price—a significant jump from 60.8% in 2022. This spike is almost entirely due to surging material prices and broad inflation. Since renovations pull from the same pool of materials and labor, those trends hit your remodel budget directly.

What does this mean for you? A quote you got six months ago might be completely out of date today. When you're building your estimate, it’s smart to factor in a contingency for potential price hikes, especially on a longer project. Staying informed helps you set realistic expectations and avoid getting blindsided by rising costs that are totally out of your contractor's control.

How to Get Realistic Quotes and Vet Contractors


Alright, you've done the hard work of creating a detailed scope of work and a spec sheet. Now you're armed with more than just a vague idea—you have a real plan. It's time to find the right professionals to bring it to life.

This phase is about so much more than just collecting prices. You're searching for a true partner, someone you can trust to see your project through from demolition to the final coat of paint.

Let's be clear: choosing the right contractor is just as critical as the design itself. A great one is your best defense against budget overruns and sleepless nights. A bad one can turn your dream renovation into a complete nightmare. Your goal isn't to find the cheapest bid, but the best value—the perfect mix of price, quality craftsmanship, and reliability.

Sourcing and Comparing Contractor Bids

Here’s the first rule of the game: never, ever go with the first quote you get. You need to get at least three detailed bids from different contractors. This isn't just arbitrary advice; it's the only way to get a real feel for the market rate for your specific project. It also makes any outliers—the suspiciously cheap or wildly expensive bids—stick out like a sore thumb.

Think a bid that's way lower than the others is a steal? It’s not. It's a massive red flag. That rock-bottom price usually means the contractor either misunderstood the scope, is planning on using cheap materials, or is banking on hitting you with a ton of change orders down the road to inflate the cost. On the flip side, an exceptionally high bid might mean they're too busy or that your project isn't the right fit for their company.

To make this all work, you have to ensure everyone is bidding on the exact same thing. Give every single contractor your detailed scope of work and spec sheet. This forces a true apples-to-apples comparison, so you can judge them on their skill and process, not just their interpretation of your vision.

Deconstructing the Proposal

As the bids come in, it's time to put on your detective hat and scrutinize them line by line. A legitimate, professional quote won't be a one-pager. It will be an itemized breakdown of costs for labor, materials, permits, and other expenses for every stage of the job.

Keep an eye out for these red flags:

  • Vague Descriptions: If you see a line item like "kitchen update" with a single price tag next to it, run. You need to see specifics, like demolition, plumbing rough-in, drywall installation, and cabinet fitting.
  • Lump-Sum Numbers: Labor and materials should never be lumped together. If they are, you have zero visibility into what you're actually paying for. Demand that they be separated.
  • Unrealistic "Allowances": An allowance is a placeholder budget for things you haven't picked out yet, like tile or light fixtures. Make sure these numbers are realistic for the quality you're after. A lowball allowance is a classic trick to make the initial bid look more attractive.

A quote is more than just a number. It’s a direct reflection of a contractor's professionalism. If they can't be bothered to put together a detailed, transparent proposal, how can you possibly trust them to manage the thousands of tiny details that make or break a renovation?

Essential Questions for Every Potential Contractor

Before you even think about signing on the dotted line, you need to conduct a thorough interview. The way they answer these questions will tell you everything you need to know about their experience and how they do business.

These are the non-negotiables:

  1. “Are you licensed and insured?” Don't just take their word for it. Ask for their license number and for copies of their general liability insurance and workers' compensation policies. Then, actually verify them. This is not a step you can afford to skip.
  2. “Who will be my main point of contact?” You need one person who is accountable for communication and who will be on-site supervising the work. You don’t want to be chasing down a different person every day.
  3. “What does your payment schedule look like?” A standard, fair schedule usually involves a small down payment (10% or less is typical), with further payments tied to the completion of major project milestones. If a contractor asks for a huge upfront payment, like 50%, that's a serious red flag.
  4. “How do you handle change orders?” Let’s face it, changes happen. A good contractor will have a clear, written process for documenting, pricing, and getting your approval on any changes before the extra work begins.

Final Vetting and Reference Checks

You're almost there. The last step is to check their track record. When you ask for references, don't just get a list of names—actually call them.

And don't just ask, "Were you happy?" Dig deeper with questions like:

  • Did the project stay on budget? If not, why?
  • How did the contractor handle unexpected problems?
  • Was communication clear and consistent throughout the project?
  • Would you hire them again in a heartbeat?

Ask to see a portfolio of their completed projects. Better yet, ask if you can visit a recently finished job site. There is no substitute for seeing their craftsmanship with your own eyes. This vetting process takes effort, but it's the absolute best insurance policy for a successful, low-stress renovation.

Building Your Final Budget and Contingency Fund

Once you have detailed quotes from contractors you trust, it's time to shift from estimating to building a rock-solid financial plan. This is the moment you bring all the pieces together—the bids, material costs, permit fees, and any other expenses—into a single master budget. This document becomes your financial roadmap for the entire project.

Think of this budget as more than just a static list of expenses; it's a living, breathing tool you'll use to track spending as it happens. A simple spreadsheet works perfectly. I always set mine up with columns for the line item, the estimated cost, the actual cost, and a notes section to keep track of payments or any changes along the way.

This kind of detailed tracking is what separates a well-managed renovation from one that spirals into a financial nightmare. It gives you a clear view of where every dollar is going and helps you spot potential overages before they blow up.

The Non-Negotiable Contingency Fund

Let's be real: no matter how carefully you plan, renovations have a knack for uncovering surprises. You tear down a wall and find unexpected plumbing or hidden termite damage. It happens. These are the "known unknowns" of any project, and your budget has to be ready for them.

This is exactly what your contingency fund is for. It's not a slush fund for splurging on fancier tiles; it’s a dedicated safety net for dealing with unforeseen problems.

A renovation budget without a contingency fund is just a wishlist. I've learned from years of experience that unexpected issues are a matter of 'when,' not 'if.'

The industry standard for a contingency fund is 10-20% of your total project cost. If you're doing a straightforward cosmetic update in a newer house, 10% might be fine. But for an older home or a project that involves moving walls or major systems, you really want to aim for 20%. Skimping here is one of the biggest and most stressful mistakes you can make.

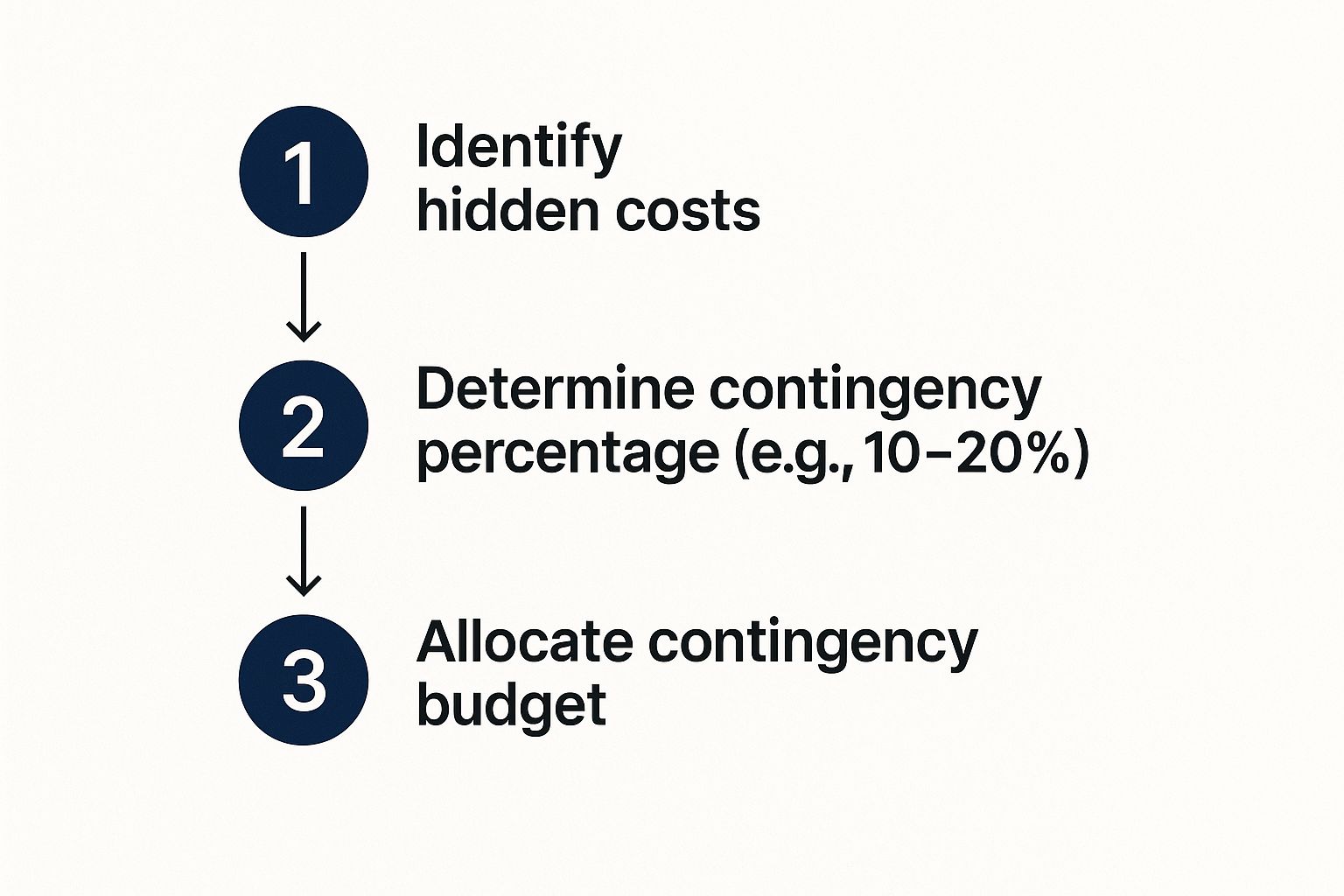

The process is simple but absolutely critical.


As you can see, it all starts with acknowledging that hidden costs are a real possibility. From there, you apply a calculated percentage to create that buffer and protect your budget.

Assembling Your Master Budget

To give you a clearer picture, here’s a simplified look at how a budget with a contingency fund comes together.

Sample Renovation Budget with Contingency

Item/TaskEstimated CostActual CostNotes
Kitchen Demolition$1,500$1,500Paid
Electrical Work$4,000$4,800Unforeseen rewiring needed
Plumbing$3,500$3,500Paid
Cabinetry & Install$12,000$12,000Paid deposit
Countertops$5,000$5,000Pending install
Subtotal$26,000
Contingency (15%)$3,900Used $800 for electrical
Total Budget$29,900

This table shows exactly how you can use the contingency to absorb an overage (like the extra electrical work) without derailing the entire project.

To build out your own master budget, follow these steps:

  • Contractor Costs: Start by plugging in all the itemized costs from your contractor's proposal. This should cover everything from demolition and framing to plumbing and finishing work.
  • Your Purchases: Next, list out all the finishes you’ll be buying yourself—appliances, tile, light fixtures, etc. Use your spec sheet to fill in the budgeted amounts.
  • "Soft" Costs: Don't forget the other expenses! This includes things like permit fees, designer consultations, and dumpster rentals.
  • The Contingency Line: Finally, add a line item for your contingency fund, calculating it as 10-20% of the subtotal of all the items above. This gives you your final, all-in project total.

This level of detail is non-negotiable. For investors, getting these numbers right is the key to a profitable flip. Our guide on using a fix and flip calculator walks through how these detailed inputs drive a reliable profit analysis. The principle is the same whether you're flipping for profit or renovating your forever home: detail gives you control.

Common Questions About Renovation Costs

Even with the most detailed plan, you're going to have questions. Estimating renovation costs is a process, and a few common uncertainties always seem to pop up. Let's tackle some of the big ones that homeowners and investors wrestle with, so you can lock in your budget with confidence.

Think of this as the practical advice you get from someone who's been there. These are the real-world insights that bridge the gap between a spreadsheet and a successful project.

How Much Should I Budget for Unexpected Costs?

This is easily the most important question, and the answer is simple: you absolutely must have a contingency fund. This isn't just "nice-to-have" money; it's a non-negotiable part of your total budget that will save you from major headaches.

The industry standard is to set aside 10-20% of your total project cost just for this.

  • For a newer home or a simple cosmetic refresh, you might get away with a 10% buffer.
  • But for an older house (think pre-1960s) or any project that involves tearing down walls, you need to be firmly in the 20% camp. No exceptions.

This fund is your financial shock absorber. It’s what you’ll use when the contractor opens a wall and finds ancient knob-and-tube wiring or discovers water damage from a leak that happened years ago. These things happen all the time, and without a contingency, they can bring your project to a screeching halt.

Here's how to think about it: a $50,000 kitchen remodel isn't really a $50,000 budget. It's a $45,000 project with a $5,000 (10%) safety net, or even better, a $41,667 job with an $8,333 (20%) fund. Plan for it from the very beginning.

Can I Save Money by Managing the Project Myself?

Acting as your own general contractor (GC) seems like a great way to save the 10-25% markup a pro would charge. And while it's possible, this path is littered with potential disasters and is definitely not for everyone.

Before you even consider it, you need to be brutally honest with yourself about your skills and, just as crucially, your time.

When you're the GC, you're the one on the hook for everything:

  • Hiring and Vetting Subs: You have to find, interview, check references, and hire every single trade—the plumber, the electrician, the drywall crew, the painter. It's a huge undertaking.
  • Scheduling the Chaos: You're the director of the orchestra. The drywall can't go up until the electrical inspection is done. If one trade is delayed, it can cause a domino effect that throws your entire timeline off by weeks.
  • Permits and Inspections: Navigating your local building department is a job in itself. You need to know which permits to pull and be available whenever the inspector decides to show up.
  • Putting Out Fires: When a subcontractor is a no-show or the wrong tile gets delivered, you're the one who has to fix it—immediately.

If you have a demanding full-time job or no real construction experience, the stress and costly mistakes can easily demolish any savings you hoped for. For most people, a good GC earns every single penny of their fee.

Why Are the Quotes I Received So Different?

Getting bids that are thousands of dollars apart is incredibly common, and it’s a big red flag telling you to look closer. A huge price gap almost always comes down to the level of detail and what's actually included—or more often, what's been left out.

That suspiciously low bid isn't a bargain; it's a warning. It probably means:

  • An Incomplete Scope: The contractor might have missed a key part of the project and will hit you with expensive "change orders" down the road to finish the job properly.
  • Cheap Materials: They could be planning to use builder-grade junk instead of the mid-range or high-end finishes you discussed.
  • Uninsured or Unskilled Labor: A rock-bottom price can sometimes mean the crew is less experienced or lacks proper insurance, which puts all the risk squarely on you.

On the other hand, a sky-high bid could mean the contractor has a lot of overhead or just isn't the right fit for a project of your size. The only way to know for sure is to compare every quote line-by-line against your detailed scope of work. If a proposal is vague, demand an itemized breakdown. A contractor you can trust will be transparent about where your money is going.


Tired of manual spreadsheets and guesswork? The entire process of how to estimate renovation costs can be simplified. Flip Smart gives real estate investors the tools to analyze any property in seconds, providing reliable renovation cost estimates, after-repair values, and profit projections instantly. Make smarter, data-driven decisions and find your next profitable deal today at https://flipsmrt.com.
